"India Has Entered a New Era in Semiconductors" Says Union Minister Ashwini Vaishnaw as CG SEMI's OSAT Facility Begins Commercial Production in Sanand
In this note
Practice
12 questions on this item
Check the answer for each question, or reveal all at once.

1. At a Glance
- India's Outsourced Semiconductor Assembly and Test (OSAT) ecosystem reached a landmark on 04 July 2026 when CG SEMI's Sanand, Gujarat facility began commercial production — a key deliverable under the India Semiconductor Mission (ISM). [1]
- Marks progress toward Atmanirbhar Bharat in a strategically critical, import-dependent technology sector (chips underpin electronics, defence, telecom, AI). [1]
- Demonstrates the social dimension of tech manufacturing — women from seven states (several tribal/hill states) employed at the facility. [1]
- High-yield UPSC topic: bridges GS-III (economy/S&T) with GS-I (social issues) and GS-II (governance/schemes).

2. Why in the News
- 04 July 2026: Union Minister for Railways and Information & Broadcasting (MeitY) Ashwini Vaishnaw announced commencement of commercial production at CG SEMI's OSAT facility in Sanand, calling it the start of a "new era" for Indian semiconductors. [1]
- Minister stated five semiconductor plants are expected to start production in India by end of 2026. [1]
- Framed as both a technical and social achievement, citing women workers from Jharkhand, Chhattisgarh, Madhya Pradesh, Bihar, Jammu & Kashmir, Kerala, and Gujarat. [1]
3. Background & Evolution

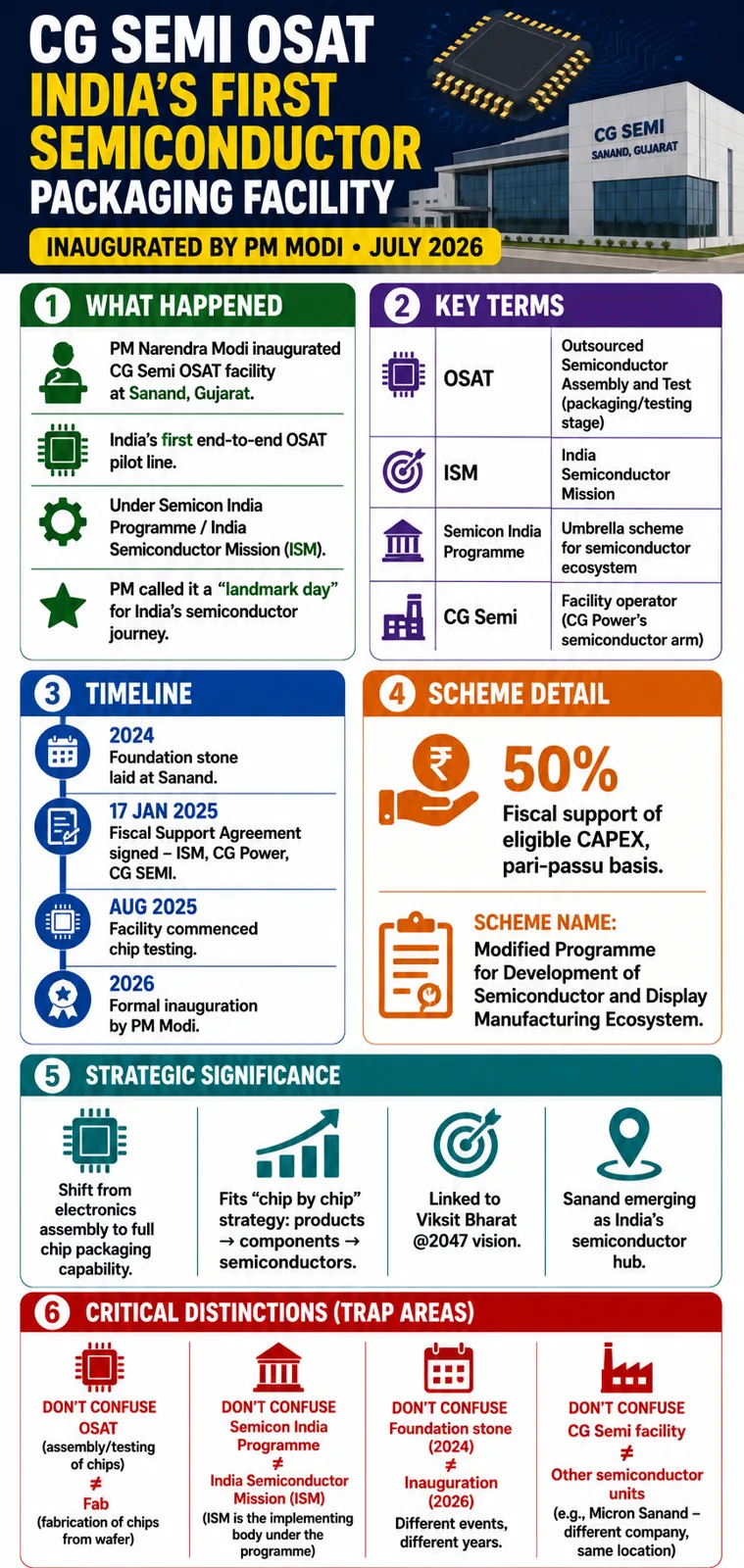

- 15 December 2021: Union Cabinet approved the Semicon India Programme with an outlay of ₹76,000 crore, launching the India Semiconductor Mission (ISM). [3]
- 13 March 2024: Groundbreaking of the CG SEMI (then CG Power) OSAT facility at Sanand. [1]
- 28 August 2025: Inauguration of one of India's first end-to-end OSAT Pilot Line Facilities (G1 unit) at Sanand — handling assembly, packaging, testing, and post-test services. [2]
- 28 February 2026 and 31 March 2026: First and second semiconductor plants under ISM began production (precursors to the Sanand OSAT going commercial). [1]
- 04 July 2026: CG SEMI's Sanand facility begins commercial production, becoming the 3rd plant in commercial production under ISM, out of 12 approved projects. [1]
- Budget 2026-27 announced India Semiconductor Mission (ISM) 2.0 with a provision of ₹1,000 crore for FY2026-27, focused on equipment/materials manufacturing, indigenous chip IP design, and supply-chain resilience — building on ISM 1.0's 10 approved projects worth ₹1.60 lakh crore across 6 states (as of December 2025). [5]
4. Core Static Facts
| Item | Detail |
|---|---|
| Nodal Ministry | Ministry of Electronics & Information Technology (MeitY) [1] |
| Implementing body | India Semiconductor Mission (ISM), under MeitY [3] |
| Parent scheme | Semicon India Programme, Cabinet-approved 15.12.2021, outlay ₹76,000 crore [3] |
| Facility in news | CG SEMI OSAT plant, Sanand, Gujarat [1] |
| Ownership | Joint venture — CG Power and Industrial Solutions Ltd. (Murugappa Group), Renesas Electronics Corp. (Japan), Stars Microelectronics (Thailand) [2] |
| Facility type | OSAT — Outsourced Semiconductor Assembly and Test (packaging/testing, not wafer fabrication) [2] |
| Investment | Over ₹7,600 crore for two facilities (G1 and G2) over five years [2] |
| Capacity | G1: ~0.5 million units/day (commercial 2026); G2 (under construction): up to 14.5 million units/day [2] |
| Jobs | G2 alone expected to generate over 5,000 jobs; ISM-linked ecosystem supports 25+ lakh jobs economy-wide [1] |
| Skilling | 70,000+ trained in chip design; 315 universities offer semiconductor design courses [1] |
| ISM approvals | 12 projects approved; 3 in commercial production (as of the news date); 10 projects worth ₹1.60 lakh crore across 6 states as of Dec 2025 [1][5] |
| First fab (wafer) location | Dholera, Gujarat (Tata Electronics) [1] |
| ISM 2.0 | Announced in Union Budget 2026-27; ₹1,000 crore provision for FY2026-27; focus — equipment/materials, indigenous IP, supply chains [5] |
| Electronics manufacturing sector size | Close to ₹13 lakh crore [1] |
5. Multi-Dimensional Analysis
Economic
- Signals India moving up the electronics value chain from assembly-only to chip packaging/testing, reducing import dependence on East/Southeast Asia. [1][2]
- ₹7,600 crore single-project investment reflects scale of FDI/JV capital being drawn into ESDM (Electronics System Design & Manufacturing). [2]
- Feeds into the broader ₹13 lakh crore electronics manufacturing ecosystem and Atmanirbhar Bharat's import-substitution goals. [1]
Social
- Employment of women from tribal/hill and conflict-sensitive states (Jharkhand, Chhattisgarh, J&K) highlighted as a social equity outcome of high-tech manufacturing decentralisation. [1]
- Skilling pipeline (70,000+ trained, 315 universities) targets youth employability in a frontier sector. [1]
Geopolitical/Strategic
- Reduces India's reliance on Taiwan/China/South Korea-dominated global semiconductor supply chains — a strategic autonomy concern post-COVID and amid US-China chip tensions. [1][2]
- International joint venture (Japan's Renesas, Thailand's Stars Microelectronics) reflects "China+1" supply-chain diversification benefiting India. [2]
- Export orientation toward Japan, US, and Europe strengthens India's role in friend-shoring of critical tech supply chains. [1]
Scientific/Technological
- OSAT is a downstream node (assembly/packaging/testing) distinct from fabrication (fab) — India's first fab is coming up separately in Dholera; distinguishing OSAT vs. fab is a key trap area. [1][2]
- Marks progress toward indigenous chip design IP (via ISM 2.0) rather than just assembly — a move up the tech-sovereignty ladder. [5]
Administrative/Governance
- Demonstrates Centre-state coordination: Gujarat government (CM Bhupendra Patel, Deputy CM Harsh Sanghavi) facilitated land/infrastructure alongside central fiscal support via ISM. [1]
- Fiscal Support Agreement model (Centre + company, e.g., CG Power/CG SEMI) is the administrative mechanism used to disburse the 50% central capital support under Semicon India Programme. [4]
6. Recent Developments (last 12-18 months)
- 28 Aug 2025: G1 OSAT pilot line at Sanand inaugurated (pre-commercial). [2]
- Dec 2025: ISM 1.0 tally reaches 10 approved projects, ₹1.60 lakh crore cumulative investment across 6 states. [5]
- Feb-Mar 2026: Union Budget 2026-27 announces ISM 2.0 (₹1,000 crore, FY2026-27); first two ISM plants begin production (28 Feb and 31 Mar 2026). [1][5]
- 04 Jul 2026: CG SEMI Sanand OSAT facility begins commercial production; Minister Vaishnaw projects five plants operational by end-2026. [1]
7. Prelims Hooks
- CG SEMI's Sanand OSAT facility is India's third plant to reach commercial production under the India Semiconductor Mission. [1]
- OSAT stands for Outsourced Semiconductor Assembly and Test — covers packaging/testing, NOT wafer fabrication. [2]
- CG SEMI is a joint venture of CG Power (Murugappa Group), Renesas Electronics (Japan), and Stars Microelectronics (Thailand). [2]
- Semicon India Programme was approved by the Union Cabinet on 15 December 2021 with an outlay of ₹76,000 crore. [3]
- Nodal ministry for semiconductors is MeitY (Ministry of Electronics & Information Technology), not the Ministry of Commerce. [1]
- India's first semiconductor fab (wafer fabrication) is coming up at Dholera, Gujarat, distinct from OSAT plants like Sanand. [1]
- 12 semiconductor projects approved so far under ISM (as of July 2026 news); 10 projects/₹1.60 lakh crore reported as of December 2025. [1][5]
- India Semiconductor Mission 2.0 was announced in the Union Budget 2026-27 with a ₹1,000 crore provision for FY2026-27. [5]
- CG SEMI's total investment for its Sanand facilities (G1+G2) exceeds ₹7,600 crore. [2]
- G1 unit capacity: ~0.5 million units/day; G2 (under construction) will scale to 14.5 million units/day. [2]
- Over 70,000 youth trained in chip design; 315 universities offer semiconductor courses in India. [1]
- Ashwini Vaishnaw holds the portfolios of Railways and Information & Broadcasting (also handles MeitY-related semiconductor announcements). [1]
8. Mains Relevance
- GS-III: Indigenization of technology, industrial policy, infrastructure, employment generation, science & tech developments and applications.
- GS-II: Government policies/interventions for development in tech sectors; Centre-state cooperation in industrial development.
- GS-I (tangential): Role of women in the economy/social change through employment.
- Possible question stems: 1. "Discuss the strategic and economic significance of India's OSAT ecosystem in reducing dependence on global semiconductor supply chains." (GS-III) 2. "Examine the difference between semiconductor 'fabrication' and 'OSAT' facilities and their respective roles in India's semiconductor value chain strategy." (GS-III) 3. "How can high-tech manufacturing initiatives like the Semiconductor Mission be leveraged as instruments of regional and gender-inclusive employment generation in India?" (GS-I/III)
9. Related Topics to Study Next
- India Semiconductor Mission (ISM) & ISM 2.0 — the parent scheme and its evolving focus areas. [5]
- Semicon India Programme, 2021 — the original ₹76,000 crore Cabinet approval. [3]
- Production Linked Incentive (PLI) Schemes for electronics — related industrial policy instrument.
- Atmanirbhar Bharat Abhiyan — overarching self-reliance framework this initiative feeds into.
- Global semiconductor supply chain & Taiwan-China tensions — geopolitical backdrop driving India's push.
- Tata Electronics Dholera Fab — India's first wafer fabrication unit, complements OSAT capacity.
- Digital India / Electronics System Design & Manufacturing (ESDM) sector — broader policy umbrella.
- Skill India / chip-design skilling initiatives — links to the 70,000-trained figure cited here.
10. Common Errors / Trap Areas
- Confusing OSAT (assembly, packaging, testing) with a fab (actual wafer fabrication) — Sanand is OSAT; Dholera is the fab. [1][2]
- Misattributing the nodal ministry — it is MeitY, not Ministry of Commerce & Industry or DPIIT.
- Confusing ISM 1.0 (₹76,000 crore, 2021) outlay with ISM 2.0 (₹1,000 crore FY2026-27 provision) — different scales and different focus (fabs/OSAT vs. equipment/materials/IP). [3][5]
- Mixing up company ownership — CG SEMI is a JV (CG Power/Murugappa Group + Renesas Japan + Stars Microelectronics Thailand), not a wholly Indian or wholly foreign entity. [2]
- Conflating the number of approved projects (12) with number in commercial production (3) — these are frequently tested as distractors. [1]
